29 Jan 2026 - we have the plasters in boarding out the rooms, a big transformation :-)
27 Jan 2026 - Lots of work on plumbing, electrics, including connection of our mains water and electricity feed
12 Jan 2026 - After a two week Christmas break it feels like we are starting to accelerate to completion. Electric first fix has seen a lot of cabling going in. See the Progress section.
26 Dec 2025 - see Tech section for an update on the importance of airtightness and the value we achieved for our first (of two) air tightness test
10 Dec 2025 - lots of progress in the last four weeks: cladding 90% complete, windows and doors in, solar roof installed, flooring insulation and base level chipboard, first fix plumbing and electrics starts
13 Nov 2025 - Progress has been a bit slow for a few weeks but the timber cladding progresses well and we had our 72 solar panels delivered today and fitting has started

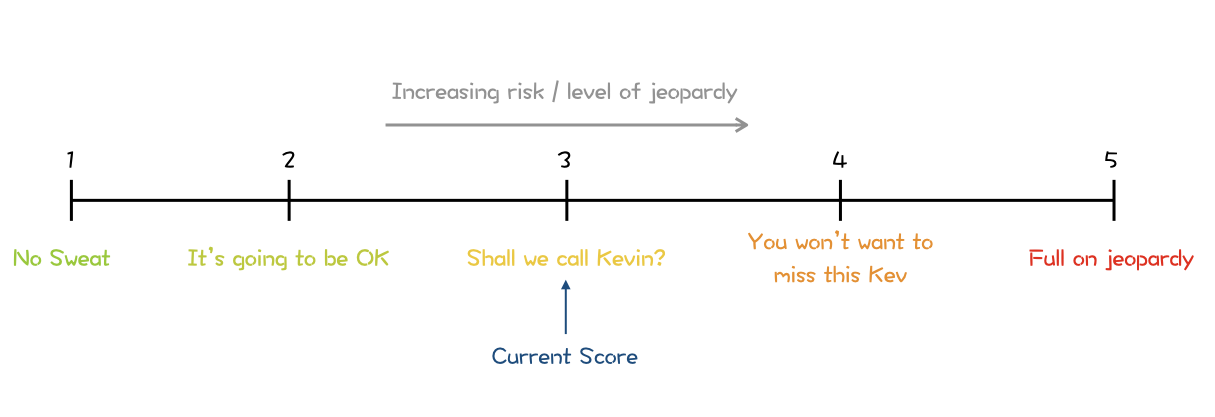

22 Oct 2025 - We have increased our Grand Designs Risk Score from 2 to 3 (see above) - see our brief blog for an explanation
3 Oct 2025 - The Devil is in the Detail blog published
25 Sep 2025 - The house is airtight and watertight (apart from a small matter of windows and doors) thanks to being wrapped in a bright red, Wraptite membrane layer
9 Sep 2025 - Another milestone today, with the help of a crane, we started to install the SIPs which are the structure for our roof.
20 Aug 2025 - A handful of slow days but progress really ramped up today with the steel posts which hold our ridge beam erected, more wall panels being erected and first floor metal web joists installed.
12 Aug 2025 - A week on and we nearly all the external walls up (see Progress for photos). More deliveries due in the next few days so we can keep up the rapid progress.

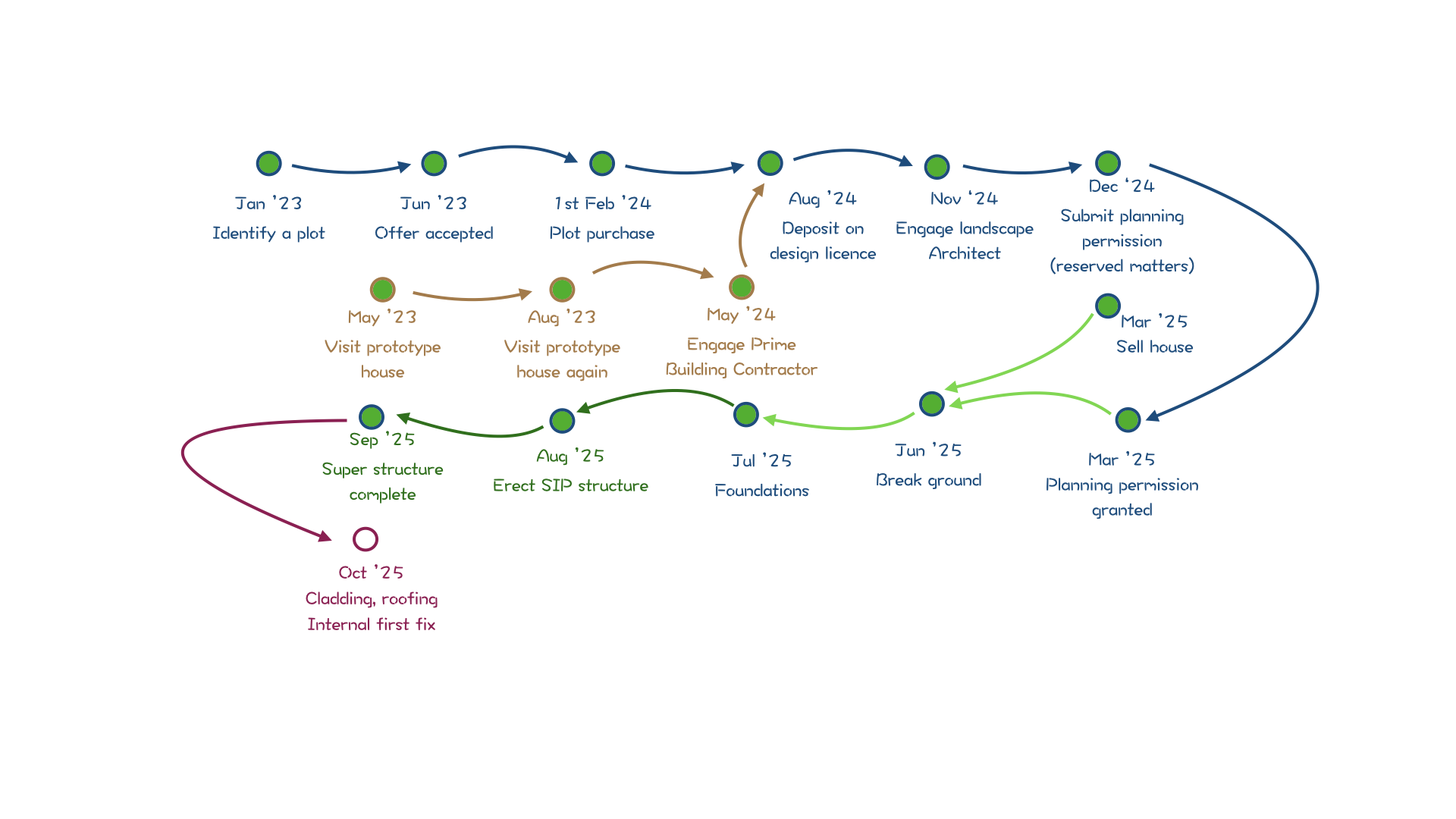

7 Aug 2025 - Another big step forward: our SIP panels arrived on site on Tuesday and after 2 days we have 22 panels (approximately half of the structural walls) in position. See our blog "Building a SIP wall for Dummies"
